Drywall Estimating

How to Estimate Drywall: A Step-by-Step Guide for Contractors

Quick answer

To estimate drywall, calculate net board area, divide by the square footage of your sheet, then add framing, screws, tape, joint compound, and waste. A 4×8 sheet covers 32 SF, 4×12 covers 48 SF. Plan on ~400 LF of tape and one 4.5-gallon bucket of compound per 400–500 SF of board, about 1 lb of screws per 100 SF, and 10–15% board waste. Then price the finish level — Level 4 is standard, Level 5 adds a full skim coat. The formulas and worked example below walk through each step.

Drywall estimating looks simple — area divided by sheet size — and that’s exactly why it gets underbid. The board is the cheap part. Framing, fasteners, tape, compound, corner bead, and especially the finish level are where the money actually lives, and every one of them scales off a different factor. This guide walks the whole chain with the numbers estimators actually use, plus the mistakes that quietly eat margin.

The drywall estimating chain: (1) net board area (walls both sides + ceilings, openings deducted) → (2) sheet count from sheet size → (3) framing: studs, track, and spacing → (4) fasteners → (5) tape, compound, and corner bead → (6) finish level (1–5) → (7) waste → (8) labor for hang and finish separately → (9) overhead and profit.

1. Calculate net board area

Drywall is estimated by board area — the surface actually covered in gypsum — not floor area and not wall length. The critical detail: a partition drywalled on both sides counts twice.

Net board area:
Wall board area = wall length (LF) × height (FT) × number of sides finished
Ceiling board area = ceiling footprint (SF)
Net area = (wall + ceiling area) − Σ openings deducted

320 LF of interior partition at 10 FT, boarded both sides, is 320 × 10 × 2 = 6,400 SF of board — from only 3,200 SF of wall face. Add ceilings separately at their footprint area.

On openings, industry practice varies. Most commercial estimators deduct full openings over roughly 32 SF (storefronts, large glazing, openings) and ignore standard door and window openings, on the logic that the cut waste around a small opening roughly equals the board removed. Whatever rule you use, apply it consistently — and remember to deduct both sides.

Common mistake: Estimating a partition once instead of twice. It sounds obvious, but on a takeoff with 40 walls it’s the single most expensive slip in drywall estimating — it halves your board, tape, compound, and finish labor in one stroke.

2. Convert area to sheets

Divide net board area by the square footage of the sheet you’re using. Larger sheets mean fewer joints to tape and finish, which is why commercial work leans on 12-footers wherever the walls allow.

Sheet sizeCoverageTypical use
4′ × 8′32 SFResidential, tight spaces, patch
4′ × 10′40 SF10′ walls, fewer butt joints
4′ × 12′48 SFCommercial standard
4′ × 14′56 SFLong open commercial runs

Sheet count: net board area ÷ sheet SF × (1 + waste %)
Example: 6,064 SF ÷ 48 SF (4×12) = 126 sheets × 1.10 = 139 sheets

Board type matters for both price and labor: 5/8″ Type X is the commercial default for fire-rated assemblies, 1/2″ for non-rated, plus moisture-resistant, mold-resistant, abuse-resistant, and cement board for wet areas. Take off each type separately — they’re different unit prices and often different hanging rates.

Common mistake: Taking off all board as one line. Fire-rated 5/8″ Type X, moisture-resistant board, and abuse-resistant board can differ substantially in price. Separate the types on the takeoff or you’ll price a rated corridor at standard-board rates.

3. Estimate framing

Most commercial drywall scopes include the metal stud framing behind the board. Studs are counted from wall length and spacing, with track (top and bottom plate) running twice the wall length.

Studs at 16″ OC: wall LF × 0.75 + 1 per wall
Studs at 24″ OC: wall LF × 0.5 + 1 per wall
Track: wall LF × 2 (top and bottom)
Then add roughly 10% for corners, door openings, headers, and backing.

320 LF of wall at 16″ OC: 320 × 0.75 = 240 studs, plus ~10% for corners and openings = ~264 studs, cut to wall height. Track: 320 × 2 = 640 LF.

Specify the stud size and gauge — 1-5/8″, 2-1/2″, 3-5/8″, and 6″ are common widths; 25-gauge for non-structural partitions and 20-gauge or heavier where the wall carries load or height demands it. Taller walls often require heavier gauge or tighter spacing, which changes both material and labor.

Common mistake: Forgetting that stud spacing is driven by wall height and board orientation, not habit. A 20-foot demising wall framed at 16″ OC in 25-gauge may not meet the limiting-height table — and if you priced it that way, the correction comes out of your margin.

4. Screws and fasteners

Screws are a small line item that’s easy to under-order. The working rule:

Screws: roughly 1 lb per 100 SF of board (about 1,000 screws per 1,000 SF at typical 12″ field / 8″ edge spacing).
Example: 6,064 SF ÷ 100 = ~61 lb of screws

Use 1-1/4″ fine-thread screws for single-layer board over metal studs; longer for double-layer or thicker assemblies. Double-layer rated assemblies roughly double the fastener count — and the hanging labor with it.

5. Tape, compound & corner bead

Finishing materials scale off board area and joint length, not sheet count. The standard planning factors:

MaterialFactorNotes
Joint tape~400 LF per 1,000 SF of boardPaper tape; mesh for repairs
Joint compoundOne 4.5-gal bucket per 400–500 SFLevel 4, three coats
Corner beadLF of outside corners × heightCount corners off the plan
Level 5 skimAdd ~50% more compoundFull-surface skim coat

For 6,064 SF at Level 4: tape = 6,064 ÷ 1,000 × 400 = ~2,426 LF; compound = 6,064 ÷ 450 = ~14 buckets. Corner bead is counted directly — every outside corner, column wrap, and soffit edge, at its height.

Common mistake: Estimating compound off sheet count instead of board area and finish level. A Level 5 skim coat can add 50% or more compound and a full extra pass of labor over the same square footage — the sheet count doesn’t change at all.

6. Price the finish level (1–5)

The finish level is the single biggest cost variable in drywall finishing, and it’s defined by industry standard (GA-214 / ASTM C840). Same board, same square footage — wildly different labor.

LevelWhat it includesWhere it’s used
Level 0No taping or finishingTemporary construction
Level 1Tape embedded in compound at joints and anglesPlenums, concealed areas
Level 2Tape + one coat over tape and fastenersGarages, warehouses, tile substrate
Level 3Tape + two coatsHeavy texture finishes
Level 4Tape + three coats, sandedCommercial standard — flat paint, light texture, wallcovering
Level 5Level 4 + full skim coat over the entire surfaceGloss/semi-gloss paint, critical lighting

Read the finish level off the architectural specs, not the drawings. If the spec calls for Level 5 in the lobby and Level 2 above the ceiling line, those are separate line items at separate rates — take them off as separate quantities.

Common mistake: Bidding the whole job at Level 4 when the spec splits levels by area. Level 5 in a glass-walled lobby under critical lighting is a materially different price than Level 4 in the back-of-house, and Level 1 above the ceiling grid should never be priced like finished wall.

7. Apply waste factors

MaterialTypical wasteWhen to go higher
Board10%15% on cut-up plans, soffits, curves, small rooms
Metal framing5–10%10% with many openings and headers
Joint compound10–15%15% on hot sites or sprayed application
Tape10%Higher with many short runs

Board waste is driven by layout, not carelessness. Long open commercial walls with 12-foot sheets can run 5–8% waste; a cut-up floor plan of small offices, closets, and soffits will run 15% and occasionally more.

8. Estimate labor

Price hanging and finishing as separate operations — they’re different crews, different rates, and different production units. Typical commercial ranges as a starting point; use your own historical rates where you have them:

OperationProduction per worker-day (8 hr)Notes
Hanging — walls40–60 sheets~2,000–2,900 SF with 4×12
Hanging — ceilings25–40 sheetsOverhead work is slower
Finishing — Level 41,000–1,500 SFAll coats combined, across days
Finishing — Level 5700–1,000 SFExtra skim pass
Metal framing60–100 LF of wallVaries with height and openings

Labor hours: sheets ÷ (sheets per day) × 8 = hanging hours; board SF ÷ (SF per day) × 8 = finishing hours.
Example: 139 sheets ÷ 50 × 8 = ~22 hanging hours; 6,064 SF ÷ 1,200 × 8 = ~40 finishing hours.

Remember that finishing spans multiple days regardless of hours — coats have to dry between passes. That’s a schedule constraint, not a labor-hour constraint, but it drives your crew loading and your GC’s expectations.

Common mistake: Rolling hang and finish into one blended rate. When the finish level changes — and it changes constantly across a commercial floor plan — a blended rate can’t flex with it, and the Level 5 areas quietly get bid at Level 4 labor.

9. Overhead & profit

Sum all direct costs — board, framing, fasteners, tape, compound, corner bead, labor for hang and finish, scaffold or lifts, and cleanup/debris. Apply overhead for insurance, supervision, small tools, and office, then apply profit.

Selling price: (direct material + direct labor + equipment) × (1 + overhead%) × (1 + profit%)

Common mistake: Leaving out debris and cleanup. Drywall generates enormous waste volume — dumpsters, hauling, and daily cleanup are real costs on a commercial job, and they belong in the estimate rather than absorbed out of profit.

Full worked example: 6,064 SF commercial TI

Office tenant improvement: 320 LF of interior partition, 10 FT high, boarded both sides with 5/8″ Type X on 3-5/8″ metal studs at 16″ OC, Level 4 finish, eight 3×7 door openings deducted both sides.

ScopeCalculationQuantity
Gross board area320 LF × 10 FT × 2 sides6,400 SF
Openings deducted8 doors × 21 SF × 2 sides−336 SF
Net board area6,400 − 3366,064 SF
Board (4×12)6,064 ÷ 48 × 1.10 waste139 sheets
Studs (16″ OC)320 × 0.75 × 1.10264 studs @ 10′
Track320 × 2640 LF
Screws6,064 ÷ 100~61 lb
Joint tape6,064 ÷ 1,000 × 400 × 1.10~2,670 LF
Joint compound6,064 ÷ 450 × 1.12~15 buckets (4.5 gal)
Hanging labor139 ÷ 50 × 8~22 hr
Finishing labor (L4)6,064 ÷ 1,200 × 8~40 hr

Price each line at your material and labor rates, sum the direct cost, then apply overhead and profit. Commercial hang-and-finish at Level 4 commonly lands in the $2.00–$3.50 per SF of board range depending on region, ceiling height, and how cut-up the plan is — so a result around $2.50–$3.00/SF on this job would be in the fairway. If your number lands well outside that, check the three usual culprits first: did you count both sides, is the finish level right for each area, and did you price hang and finish separately.

ScopeTakeoff plan takeoff showing a drywall partition detail on the sheet, with drywall measured directly off the drawing
Reading the wall types off the plan in ScopeTakeoff. Partition details and wall runs are measured straight off the sheet with the scale already set — so board area, both sides, comes from the drawing rather than a separate spreadsheet.

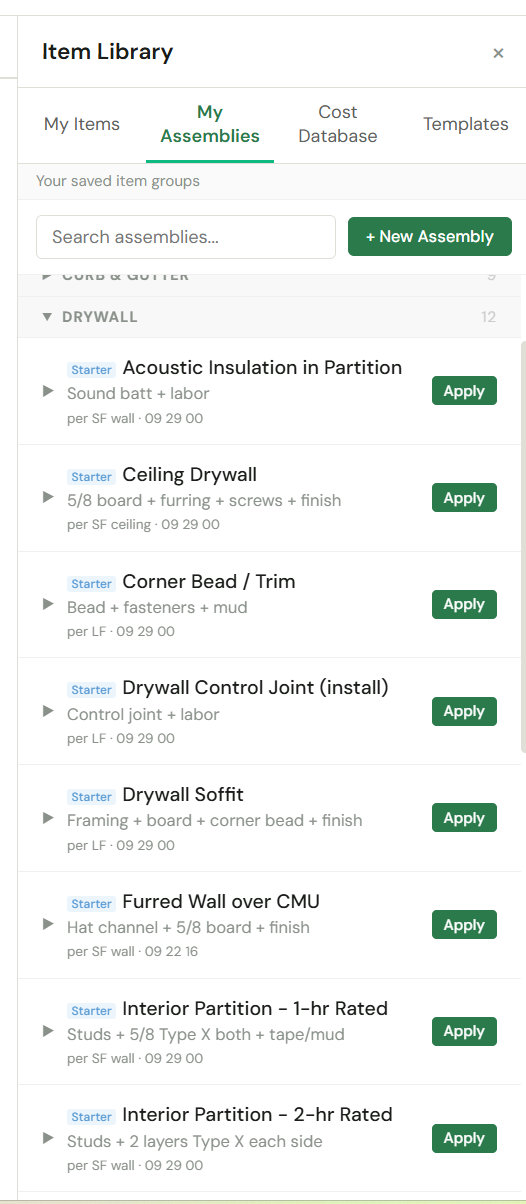

ScopeTakeoff drywall assembly library showing starter drywall assemblies that bundle board, metal framing, screws, tape, joint compound and labor per square foot of wall
ScopeTakeoff’s drywall assembly library. Each assembly bundles board, framing, fasteners, tape, compound, and labor — so one measured wall produces every quantity in this guide at once, at the finish level you pick.

Want to skip the spreadsheet? ScopeTakeoff’s drywall assemblies run this entire chain automatically — measure the wall once, pick the board type and finish level, and it derives sheets, studs, track, screws, tape, compound, waste, and hang-and-finish labor hours, then rolls it into a Schedule of Values for the GC. See drywall estimating software →

FAQ

How many sheets of drywall do I need?+
Divide your net board area by the coverage of your sheet, then add waste. A 4×8 sheet covers 32 SF, 4×10 covers 40 SF, and 4×12 covers 48 SF. For example, 6,064 SF of board using 4×12 sheets is 6,064 ÷ 48 = 126 sheets, plus 10% waste = 139 sheets. Remember that a partition finished on both sides counts twice.
How do you calculate drywall square footage?+
Multiply wall length by wall height, then multiply by the number of sides being boarded — a partition drywalled both sides is length × height × 2. Add ceiling area at its footprint. Then deduct large openings (most commercial estimators deduct openings over about 32 SF and ignore standard doors and windows, since cut waste roughly offsets them).
How much joint compound and tape do I need?+
Plan on roughly 400 linear feet of joint tape per 1,000 SF of board, and about one 4.5-gallon bucket of joint compound per 400–500 SF of board for a standard three-coat Level 4 finish. A Level 5 skim coat adds roughly 50% more compound. Add 10–15% waste to both.
What is a Level 4 drywall finish?+
Level 4 is the commercial standard finish: joint tape embedded in compound plus three separate coats over joints, angles, and fasteners, sanded smooth. It’s specified for flat paints, light textures, and wallcoverings. Level 5 adds a skim coat over the entire surface and is specified where gloss or semi-gloss paint or critical lighting will reveal imperfections. Levels are defined by GA-214 / ASTM C840.
How many studs do I need for a drywall partition?+
At 16″ on center, multiply wall length in feet by 0.75 and add one per wall; at 24″ on center, multiply by 0.5 and add one. Then add roughly 10% for corners, door openings, headers, and backing. Track runs twice the wall length for top and bottom. Confirm stud width and gauge against the limiting-height requirements for the wall.
What is a typical drywall waste factor?+
Board typically runs 10% waste, rising to 15% on cut-up plans with small rooms, soffits, and curves, and dropping toward 5–8% on long open commercial walls with 12-foot sheets. Metal framing runs 5–10%, joint compound 10–15%, and tape about 10%.
How much does drywall cost per square foot?+
Commercial hang and finish at Level 4 commonly runs about $2.00–$3.50 per square foot of board, depending on region, ceiling height, board type, and how cut-up the plan is. Level 5, high ceilings, and rated assemblies push it higher. These are planning ranges — your real number comes from pricing board, framing, fasteners, finishing materials, and hang-and-finish labor at your own rates, then applying overhead and profit.
ST
ScopeTakeoff Editorial
Written by the ScopeTakeoff team — estimating software built for subcontractors. Our content is based on practical construction estimating workflows across drywall, framing, and commercial subcontractor bidding.

Estimate drywall faster with ScopeTakeoff
